introduction introduction
Egypt to Kalamaki,Greece - Steel structure oil project transport
First Global Logistics Egypt has been appointed to Handle the Transportation of Egyptian origin Steel structure Project cargo from Alexandria ,Egypt up to Kalamaki in Greece .These Steel Structures are used for the Oil and Gas sector Plant procurements .Based on a detailed Technical operations Plan and a precise financial proposal covering all Project transport aspects presented by our company Project team , hopefully it resulted by our nomination to take the physical steps to make the Job done on ground .
Scope of work
Our scope of work included the following :
- Job Site visit for cargo survey and measurements.
- Detailed Road survey through the Trucking team for Road feasibility for OOG cargoes.
- Vessel Voyage Chartering from Liner in Alexandria port to Free out Kalamaki port .
- More than 35 Trailers mixed of Modular Trailers – Low Loaders – Flat beds were used in the Inland Haulage from Sipper’s Site up to FAS Alexandria port .
- Loading and on board Marine survey .
- Export customs clearance
- Obtaining OOGs road permits and Police traffic escorts .
- Road Civil works and removals by using and temporarily removing Dekheila port Emergency gates for entering Critical dimensional OOGs .

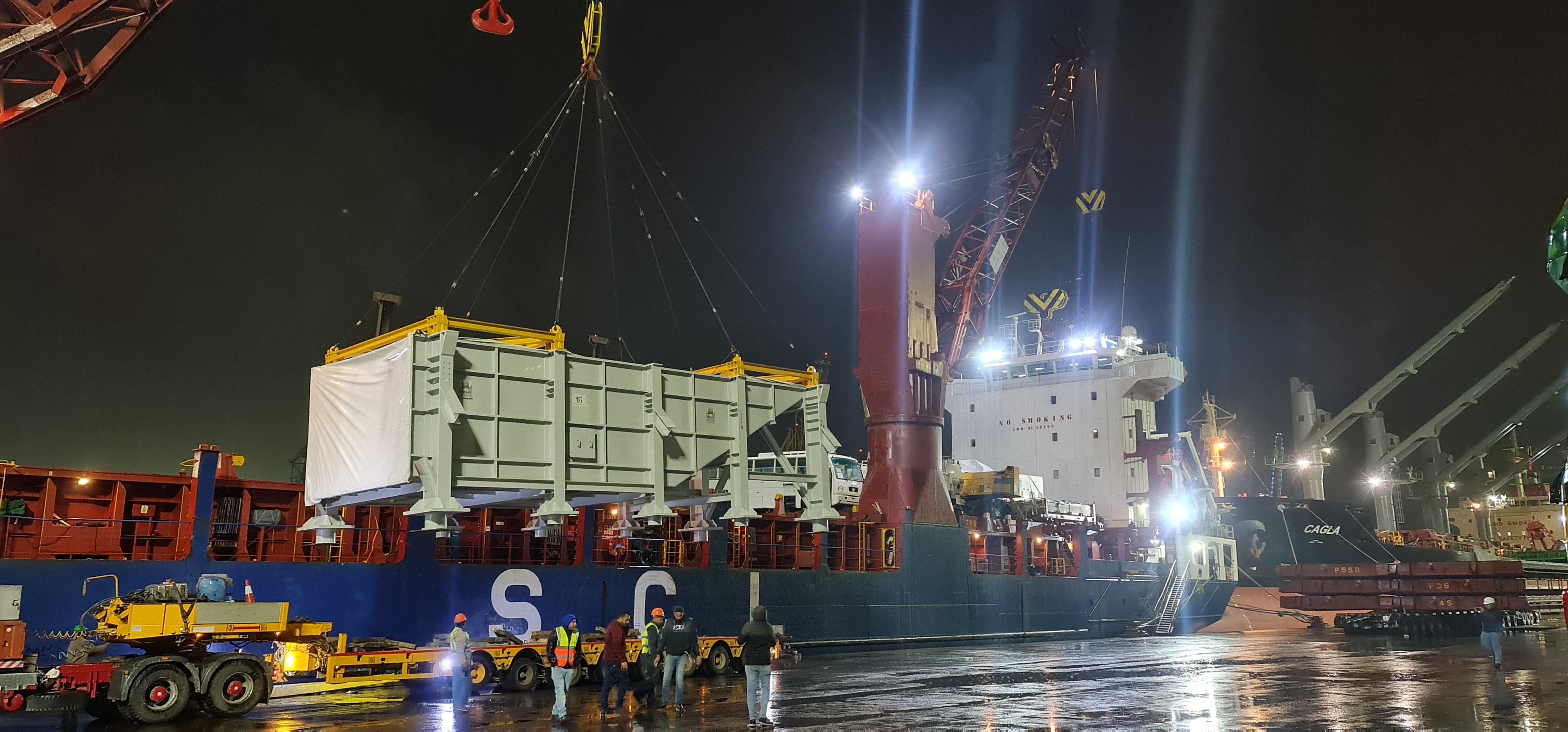

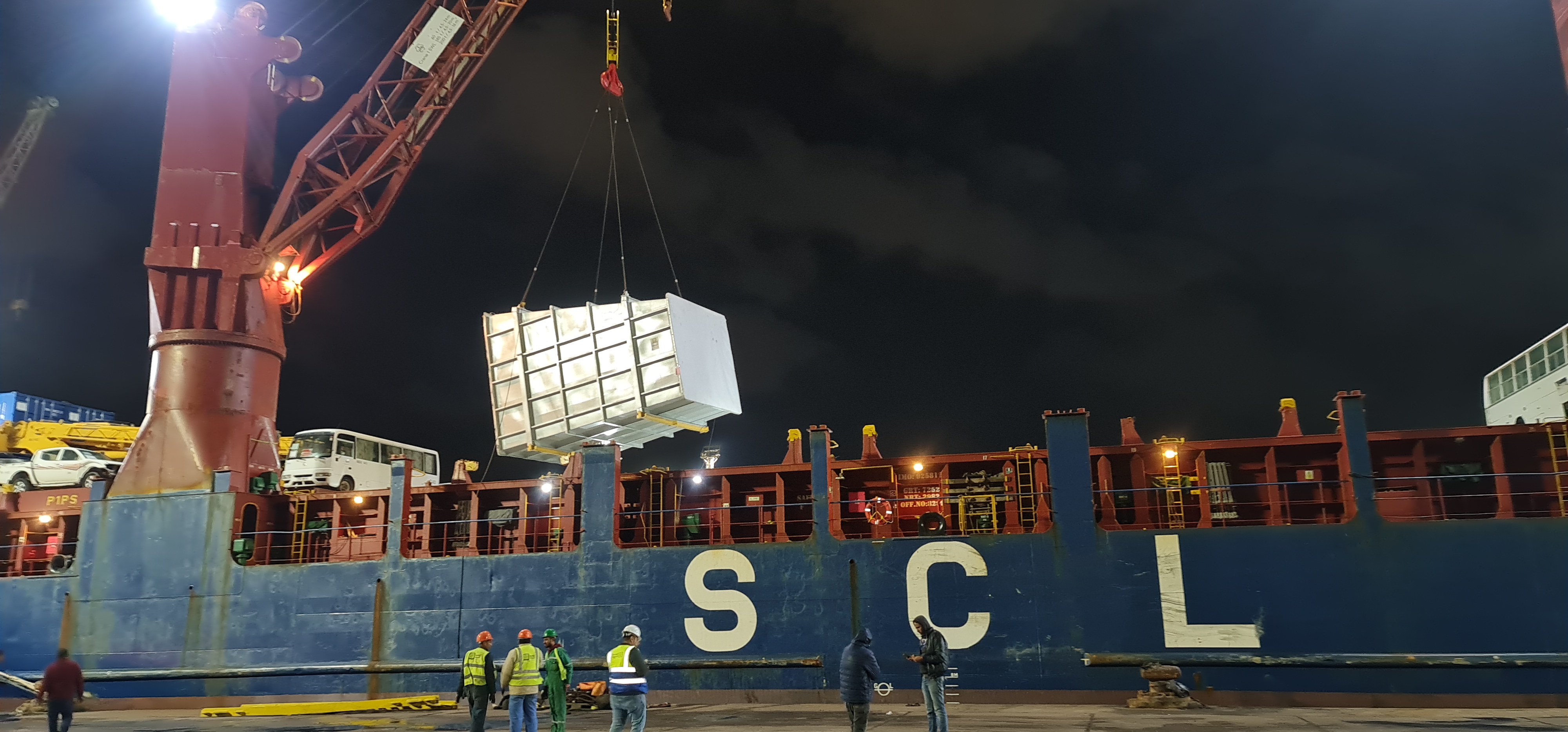

- Stevedoring and loading Port operations
Cargo and job description
- Vessel Owners : SCL Mercury
- Length : 119,8 m
- Terms of shipping : Liner in/Free out
- Port of loading : Dekheila Port , Alexandria
- Port of Destination : Kalamaki port , Greece
- Quantity : 44 Units
- Description : Steel Structures
- Origin : Egyptian origin cargo
- Critical Dimensional OOGs :
- Total Shipment G.W : 545,000.00 kgs
- Total Shipment Volume : 2605 CBM
Obstacles
This project main challenge was the direct delivery from Shipper’s site directly to on board vessel .
The Charter vessel initial Berth date was 10th February 2024 , so the 1st 19 Trailers were available on Site the day before 9th morning so the shipper and our trucking team can take their full day to load , lash and move on the roads according the road studies and calculations so we needed 24 hrs from Site to Vessel passing by Road toll station , moving the critical OOGs with care , removing the port gates , finalizing export clearance at port .Unfortunately a force majeure of bad weather ;heavy showers and winds came in front the same day caused the vessel on hold out of anchorage for 4 full days with Dekheila port vessels congestion .
Vessel finally berthed 14th February and job was done during the bad weather in less than 72 hrs and all the Trailers were waiting FAS and all cargo have reached Kalamaki port safely in good conditions .
We faced four days of delays and Trailers waiting FAS which occurred huge amounts of truck detention but due to customer understanding to the force majeure conditions and our successful direct delivery scope of work they have covered these amounts amicably and all parties are satisfied
